How to Start Your Own Tiny House Community: A Step-by-Step Business and Zoning Guide

Human Verified 0

Share to: , and

how to start a tiny house community

Every established tiny house community has a waitlist, and every waitlist is unmet demand with nowhere legal to park. Building a village yourself is the most ambitious project in the tiny house world — part real estate development, part legal chess, part community organizing. This guide is the complete build order, from proving demand to full occupancy, including the pitfalls that killed other people’s villages.

How to Start a Tiny House Community: At a Glance

Learning how to start a tiny house community means accepting that it is a development project before it is a housing idea. Demand for legal tiny house parking massively exceeds supply, which is why the opportunity is real — but the projects that succeed treat land, zoning, legal structure, infrastructure and financials as one connected sequence, in a strict order: prove the demand, secure the legal path, then buy, then build, then fill. Get the order wrong — buy the land before the zoning, build all the lots before leasing the first — and the same demand that makes communities valuable cannot save the project. The ten steps below follow that order end to end. Founders who want to see what the finished product looks like when the legal work is done well can study the tiny house villages that cleared the legal hurdles and how each one structured its approval.

Step What It Decides Key Figure
1. The Vision and the Market The concept, the model and proof that residents exist 12–30 lots is the first-project sweet spot
2. Land The make-or-break purchase, sized and priced per lot 0.5–1 acre per 4–6 lots
3. Zoning and Entitlement The legal path: RV park, PUD, MH park or new ordinance Budget $20,000–80,000 for entitlement
4. Legal Structure Who owns what: leases, co-op, condo or land trust The documents are the community’s constitution
5. Infrastructure Roads, pads, power, water and sewage — the capital core $15,000–40,000 per lot, all-in
6. Financials Rents, occupancy, expenses and the phased capital plan Model 85% stabilized occupancy
7. Governance Rules that build community instead of resentment The best rules fit on two pages
8. Marketing and Lease-Up The waitlist, the founding offer and the open house Build the waitlist before breaking ground
9. Operations Management, maintenance and reserves, year after year Hold 6 months of expenses in reserve
10. The Pitfalls The six failure patterns that killed other villages Land before zoning is the #1 killer

how to start a tiny house community

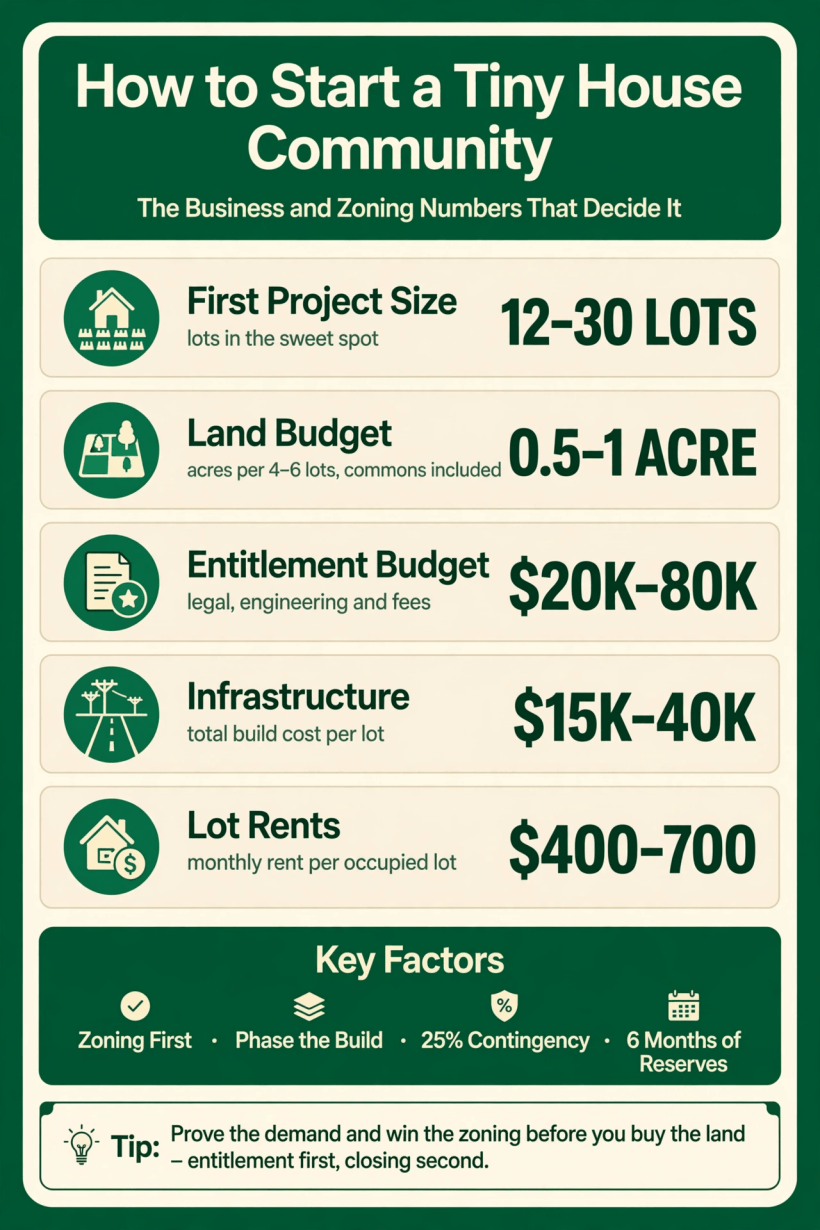

The founder’s numbers at a glance: a 12–30 lot first project, half an acre to an acre per 4–6 lots, $20K–80K of entitlement budget, $15K–40K of infrastructure per lot, and lot rents of $400–700 a month.

1. The Vision and the Market: Prove the Demand

Before spending a dollar, define the community on paper. How many lots — 10, 30, 100? For first projects, 12–30 is the sweet spot: large enough to carry the shared infrastructure, small enough to entitle, finance and fill without heroic assumptions. Which model: lot leases, lot sales, or cooperative ownership? Which resident: full-time families, retirees, workforce housing? Each answer changes the design, the legal structure and the marketing that follow. A focused concept — the way tiny house communities for seniors are designed around one clear resident profile — is far easier to approve and to fill than a village trying to be everything at once.

how to start a tiny house community: aerial view over a thriving, fully occupied tiny house village, the demand a new project serves

Then validate the demand instead of assuming it. Survey the local tiny house community where it actually gathers — Facebook groups, meetups, builder waiting lists. Talk to builders: they know exactly where their buyers cannot find legal parking, and that frustration is your market research, already collected. Study comparable communities’ occupancy: a village that is full with a waitlist is a proven market; a half-empty one is a warning about location or pricing. This step costs almost nothing and decides almost everything, because a community nobody wants is just expensive land with good intentions.

2. Land: The Make-or-Break Purchase

Land is where communities are made or buried, and the criteria are unforgiving. The zoning must allow the use — or offer a realistic path to approval, which is the subject of the next step. Utilities must be available or feasible: well and septic capacity for the lot count you plan, and grid power close enough that bringing it in does not eat the project. Access matters more than newcomers expect — roads must accommodate tiny house delivery, and a 30-foot house needs a real turning radius, not a driveway designed for cars. On size, plan roughly 0.5–1 acre per 4–6 lots, including common space and infrastructure.

how to start a tiny house community

Price discipline keeps the finished village affordable: land cost per lot should stay under $15,000–25,000, or the lot rents needed to service the land will price out the residents the project exists for. The general discipline of hunting for workable parcels is covered in our guide to where to buy tiny house lots — the community version simply runs the same checks at village scale. Before closing, complete the due diligence: perc tests, because septic capacity determines the lot count; a survey; a title search; and an environmental check, because wetlands and floodplain both kill projects. Hold a pre-application meeting with planning staff before you close, not after. And never buy land before confirming the zoning path — the “great deal” on unusable land is the classic community-killer.

Entitlement is the legal permission to build, and there are four strategies, ranked from easiest to hardest. First, RV park zoning: where the code allows RV parks, a tiny house community often qualifies, with the houses on wheels treated as RVs — this is the established path, and the practical differences between the two models are laid out in our comparison of tiny house communities vs RV parks. Second, the planned unit development (PUD): a custom zoning overlay negotiated with the jurisdiction — flexible, but slow, at 12–24 months. Third, manufactured home parks: some jurisdictions allow tiny houses in existing MH parks, so check the definitions. Fourth, an ordinance amendment: proposing new tiny-house-community zoning from scratch — the longest path, but the one that creates permanent legal infrastructure for everyone who follows.

how to start a tiny house community: presenting the community site plan to officials at a public planning hearing

Budget $20,000–80,000 for the entitlement process itself — attorneys, engineers, application fees and hearings — and treat that money as the project’s foundation, not an overhead to minimise. How you handle the human side of this process matters as much as the paperwork: our guide to talking to zoning officials about tiny house laws covers the research, vocabulary and framing that turn a skeptical planning office into a workable counterpart. Neighbours belong in this step too — adjacent property owners can kill entitlements, so engage them early and genuinely, while the plan can still absorb their concerns.

With the legal path clear, decide who owns what. Four models dominate. Developer-owned lot leases are the simplest: you own the land, residents lease lots, and you keep the asset and the control. A cooperative puts ownership in residents’ hands collectively — complex to set up, but resilient over the long term because the community’s interests and the owner’s interests are the same people. The condominium model sells lots as condo units inside a familiar legal framework, at the price of complex documents. And the nonprofit or community land trust model is mission-driven: eligible for grants, and structured to stay permanently affordable.

how to start a tiny house community: founders and their attorney reviewing the ownership documents and site plan

Each model carries different financing, tax and governance implications, and the choice is hard to unwind later — which is why the standing advice is to engage a real estate attorney experienced in the chosen model before finalizing anything. The documents the attorney produces — the leases, the CC&Rs, the bylaws — are the community’s constitution: they decide what happens in every future dispute, sale, succession and rule change. Founders who treat the paperwork as a formality discover, usually at the worst moment, that the paperwork was the project.

5. Infrastructure: Building the Village Systems

Infrastructure is the capital core of the project — the physical systems every lot depends on. Roads and pads come first: gravel roads run $15,000–30,000 per mile, and concrete pads $2,000–4,000 each. Electrical follows: a pedestal per lot at $1,500–3,000 each installed, with the transformer and distribution sized to the community’s total load rather than to its first phase. Water means a well plus distribution, or a municipal connection, at $30,000–100,000 or more depending on scale. Sewage is the biggest variable of all: a community septic system or sewer connection runs $50,000–200,000+ for engineered systems serving 20 or more lots. Add the common buildings — laundry, community hall, office — at $50,000–150,000, plus landscaping and screening. The all-in total: $15,000–40,000 per lot for a mid-range community.

how to start a tiny house community: crews trenching utilities and setting electrical pedestals beside fresh concrete pads

Two disciplines protect this budget. The first is engineering honesty: the utility decisions — how power reaches each lot, where water comes from, how sewage leaves — are exactly the systems detailed in our guide to tiny house utilities, power, water and off-grid sewage, and they must be sized for the full build-out even when construction is phased. The second is contingency: sewage and water always cost more than projected, so the infrastructure budget carries a 25% contingency as a matter of policy, not optimism. Underspend it and the surplus funds the next phase; skip it and the first surprise becomes a financing crisis.

6. Financials: Making the Numbers Work

The pro forma is where the vision meets arithmetic. Revenue is lot rents of $400–700 a month multiplied by lots and occupancy — and the occupancy to model is 85% stabilized, not the 100% of founder optimism. Expenses — debt service, utilities, maintenance, management, insurance, taxes and reserves — typically run 40–55% of gross revenue. Capital is the sum of everything before it: land plus entitlement plus infrastructure, totalling $500,000–2,000,000 for a 15–25 lot community. On the return side, stabilized communities trade at 7–10% cap rates, and the developer’s return comes from cash flow plus land appreciation rather than from flipping lots.

how to start a tiny house community: the developer reviewing the project budget in the site office as the first phase takes shape outside

Financing follows the same conservative shape: commercial loans (expect 25–35% down, on 5–7 year terms with amortization), investor partnerships, or phased development. The mechanics of borrowing against a small dwelling project echo the lender logic in our guide to how to finance a tiny house — classification and documentation decide what a lender will touch. Above all, phase the build: it is the number-one risk management strategy in this guide. Phase 1 of 8–12 lots proves the concept, generates cash flow and funds Phase 2. Never build all 30 lots before leasing the first.

7. Governance: Rules That Build Community

Governance is the project’s operating system, and it lives in three documents. The CC&Rs or community rules set the design standards, maintenance obligations, quiet hours, pet policies and guest policies. The lease or occupancy agreement sets rent, term, termination and house standards — including RVIA certification requirements and any age limits on houses. And the governance structure itself starts developer-managed, with a written transition plan toward resident governance for cooperatives. Writing these documents well is a design task, not a legal chore: they shape daily life for every resident, every day, for decades.

how to start a tiny house community

The principle that separates good rulebooks from resented ones: write rules for the community you want. Keep them clear, enforceable, and focused on genuine externalities — noise, aesthetics, safety — rather than on control for its own sake. Every rule should answer a real problem a neighbour can actually cause or suffer; rules that exist to express the founder’s taste become enforcement burdens and lease-up repellent. The benchmark from experienced operators is almost embarrassingly simple: the best community rules fit on two pages. If yours runs to twenty, the document is managing the founder’s anxiety, not the village.

8. Marketing and Lease-Up

Lease-up begins long before the first lot exists. Pre-marketing runs during entitlement: build the waitlist before breaking ground, because a 50-person waitlist de-risks everything that follows — the financing conversation, the phasing decision, the founders’ sleep. Tiny house people live online, so the digital presence — a proper website, virtual tours, active social media — is not decoration; it is where your residents already are. Builder partnerships are the other high-yield channel: builders know every buyer who cannot find parking, and a community that solves their customers’ problem earns referrals no advertising can buy.

how to start a tiny house community: founding residents moving into their tiny house on open house day

Two offers convert the waitlist into residents. The founding resident offer — discounted first-year rent for the pioneers willing to tolerate a community still under construction — rewards the people whose presence makes the place real for everyone after them. And the open house does what no rendering can: nothing sells a community like walking the finished Phase 1, standing on a real pad, and picturing a specific house on it. Treat lease-up velocity as the survival metric it is. Every empty lot-month burns cash against fixed debt and fixed costs, which is why marketing is a step in the build order and not an afterthought once construction ends.

9. Operations: Running the Village

Opening day is the midpoint, not the finish line. Ongoing operations are rent collection and bookkeeping; maintenance of roads, common areas and utilities, budgeted at 5–8% of gross revenue; resident relations; rule enforcement that is consistent, documented and humane; and financial reserves of six months of expenses, minimum — because infrastructure failures do not wait for good quarters. The single most important operational decision is a person: the community manager is the most important hire in the project, the one who turns a collection of lots into a place residents renew in.

Professional management, at $2,000–4,000 a month for a 20-lot community, pays for itself in retention and maintenance discipline — every long-term resident it keeps is a lot that does not need re-marketing, and every small repair it catches early is a capital project that never happens. Insurance belongs in the same operating budget conversation, structured around how the houses actually sit; our tiny house insurance guide for wheels vs foundation walks the wheels-versus-foundation cover the operator and the residents each need. Run the village like the small business it is, and operations become the quiet engine that funds every later phase.

10. The Pitfalls: Learn From Others’ Failures

The failure patterns repeat so reliably that they read as a checklist. First and deadliest: buying land before zoning confirmation — entitlement first, closing second, always. Second: underestimating infrastructure, because sewage and water always cost more than projected; the defence is the 25% contingency, held sacred. Third: overbuilding Phase 1 — thirty empty lots is a bankruptcy in progress, while eight full lots is a business. Fourth: no reserves, which converts the first septic failure from an expense into an extinction event.

Fifth: founder burnout. Communities take 3–5 years to stabilize, and a project that depends on one person’s unlimited stamina has a single point of failure — plan your endurance and your succession with the same care as the site plan. Sixth: ignoring the neighbours. Adjacent property owners can kill entitlements, stall hearings and poison a jurisdiction against the next project too; the founders who engage them early and genuinely rarely regret the hours it cost. None of these pitfalls is exotic. Every one of them has ended real villages whose demand, land and intentions were perfectly good — which is precisely why they are worth learning on paper instead of in person.

Final Considerations

Starting a tiny house community is development work with a mission: every legal lot you create houses someone the current system fails. The honest numbers frame the commitment — a path of 3–5 years from vision to stability, and capital of $500K–$2M for a mid-size village — but the demand is proven, the model works, and the need grows every year. The sequence is the strategy: prove the demand, win the entitlement before the land purchase, choose the structure deliberately, phase the build, and reserve for the surprises.

That is how to start a tiny house community that is still standing in year five: respect the order of operations, let each phase fund and de-risk the next, and build the village the movement actually needs — legal, affordable, and full.
