The house gets the Pinterest board; the land gets whatever is left over. That is backwards. Site preparation, permits, excavation, and utility hookups routinely cost as much as the structure and take longer than the build, and skipping steps here is how dream projects stall in the mud.
This is the complete site-preparation checklist in working order: due diligence before purchase, the permit sequence, clearing and access, excavation and drainage, foundation or pad, utility hookups, and the real budget. Do it in this order and the land becomes the quiet foundation instead of the loud problem.
The Land Is the Project
New tiny house owners obsess over the house and neglect the land — then discover that site preparation costs as much as the structure and takes longer than the build. Permitting, excavating, and utility hookups are the unglamorous foundation everything stands on. This guide is the complete site preparation checklist, in order.
1. Due Diligence Before Purchase
Never buy land for a tiny house without: a perc test (septic feasibility — $500–1,500; failed perc can kill the project), a survey (boundaries, easements, setbacks — $500–2,000), a title search (liens, restrictions, HOA covenants that prohibit tiny houses), zoning verification (written confirmation from the planning department that your house type is allowed), floodplain/wetland check (FEMA maps + a site visit after rain), and utility distance assessment (how far to power, water, sewer — every foot costs money). The $3,000–5,000 of due diligence prevents the $50,000 mistake.
The contingency clause: make the purchase offer contingent on perc test and zoning confirmation. Walk away if either fails; the earnest money is cheaper than the land.
2. Permitting: The Paperwork Phase
The permit sequence: zoning approval (confirm the use is allowed; get it in writing), building permit (submit plans — site plan, floor plans, elevations, structural details; fees $500–3,000), septic permit (separate application in most jurisdictions; requires the perc test and a system design), well permit (where applicable), electrical/plumbing permits (often separate trades permits), and driveway/culvert permit (access from a public road usually requires one). Timeline: 2–6 months in most jurisdictions. Start permits before finalizing the house design — the permit requirements shape the design.
3. Clearing and Access
The physical work begins: clearing (remove trees and brush from the building envelope plus working space — $1,500–5,000 for selective clearing; keep the valuable trees), driveway (gravel driveway $5,000–15,000 depending on length and terrain; it must support delivery trucks and concrete mixers — build it for 40,000 lbs), culvert (where the driveway crosses a ditch — $500–2,000 installed, often permit-required), and staging area (flat space for material delivery and construction — plan it before the trucks arrive). Access first: nothing happens on landlocked land.
4. Excavating and Grading

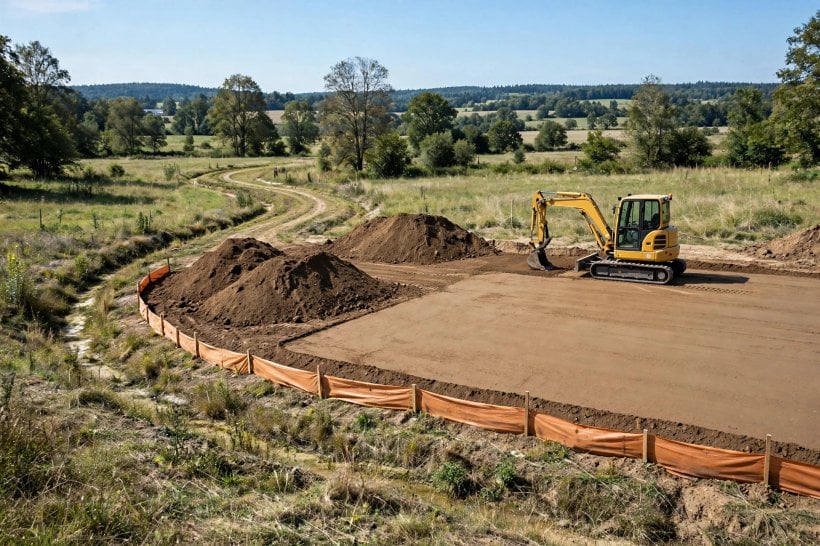

Earthwork: grading the pad (level the building site with proper drainage away from the structure — 6 inches of fall in the first 10 feet minimum), foundation excavation (for foundation houses: excavate to frost depth per local code; for THOWs: prepare the pad — compacted gravel, 6+ inches, on geotextile fabric), drainage (French drains where water collects; swales to redirect runoff — water management is the difference between a dry house and a damp one), and erosion control (silt fence during construction; seed or mulch disturbed areas after). Excavation budget: $3,000–12,000 for a typical tiny house site.
Drainage rule: every site problem is a water problem. Spend the drainage money; it is the cheapest insurance on the property.
5. Foundation or Pad

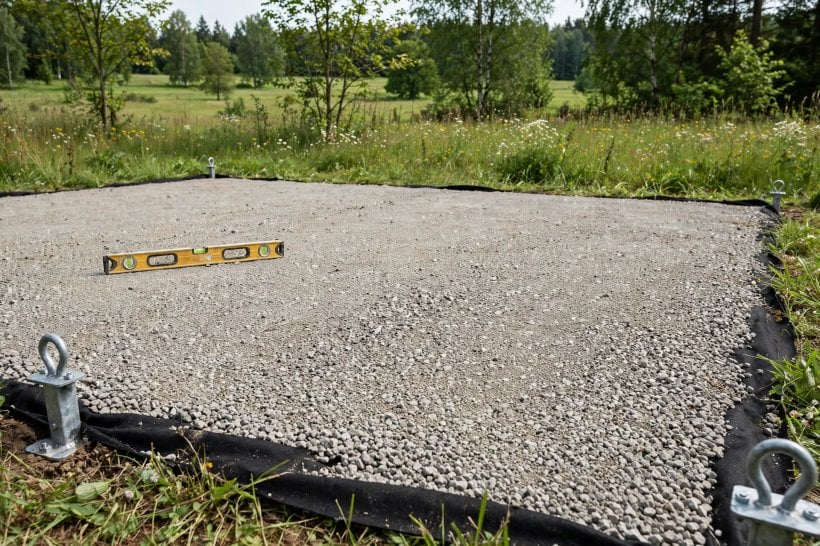

For foundation houses: the foundation per the engineered plans (piers, slab, or crawlspace — $5,000–15,000 for tiny scale), inspected before framing. For THOWs: the parking pad (compacted gravel on geotextile, or concrete pad $3,000–8,000), leveled to within an inch, with tie-down anchors where required (hurricane/seismic zones). The pad is permanent infrastructure — build it like the house depends on it, because it does.
6. Utility Hookups: Power

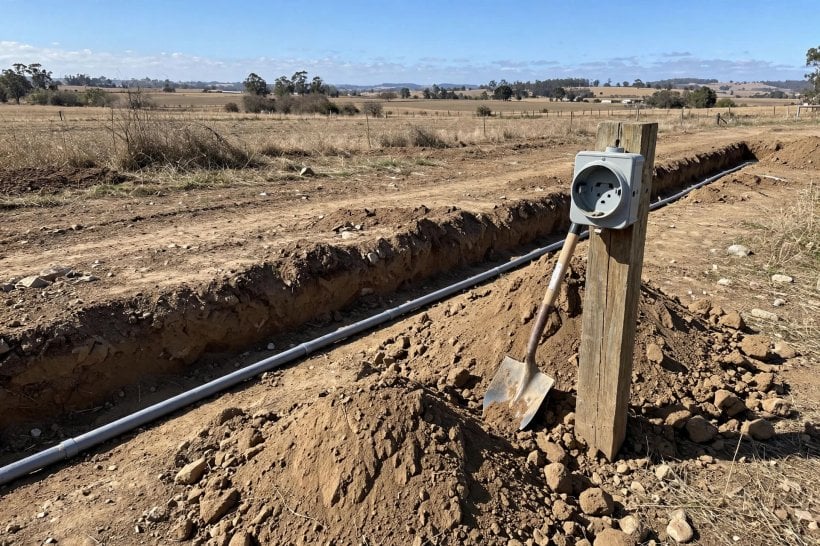

Grid power: apply early (utility lead times run 2–6 months), trenching (underground service — $10–25/foot trenched; overhead is cheaper but uglier and more vulnerable), meter base and panel (installed by your electrician, inspected before the utility connects), and temporary power (a temp pole for construction — $500–1,500 — so the build is not waiting on the permanent service). Off-grid power: install the solar array and battery system during construction (the roof is the mount; the utility room is the battery home — design them in).
7. Utility Hookups: Water and Sewage

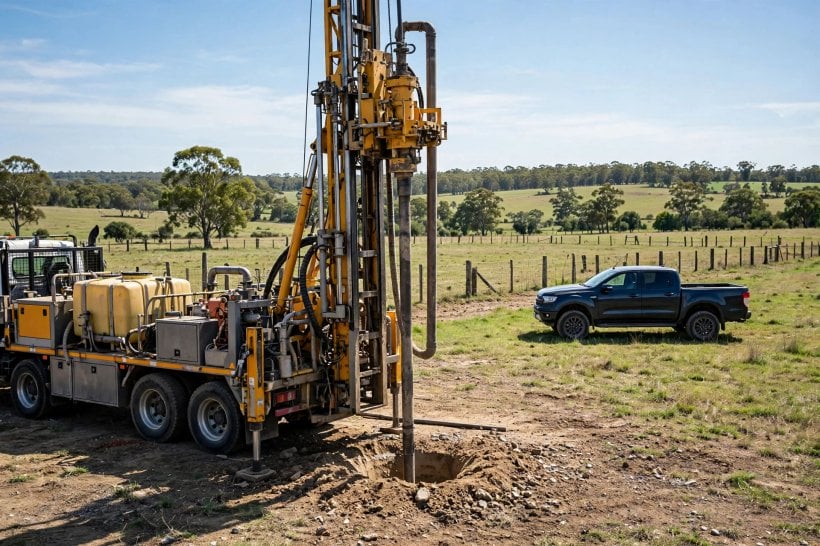

Water: well drilling ($5,000–15,000; schedule early — drillers book months out; drill before construction so water is available for the build), or municipal connection (tap fees $1,000–5,000; trench the service line). Sewage: septic installation ($8,000–25,000; install after the house location is final but before heavy construction traffic compacts the drain field area — protect the field), or sewer connection (tap fees $2,000–8,000). Critical sequencing: septic drain field location must be protected from construction traffic — fence it off on day one.
8. Internet and Final Grading
Connectivity: trench conduit for internet alongside the electrical trench (cheap now, expensive later — always bury spare conduit), or confirm Starlink sky view (the rural default). Final grading: topsoil replacement, seeding, and landscaping (the site should look intentional, not excavated — neighbors and inspectors both notice). Budget $1,000–3,000 for the finish work that makes the property look finished.

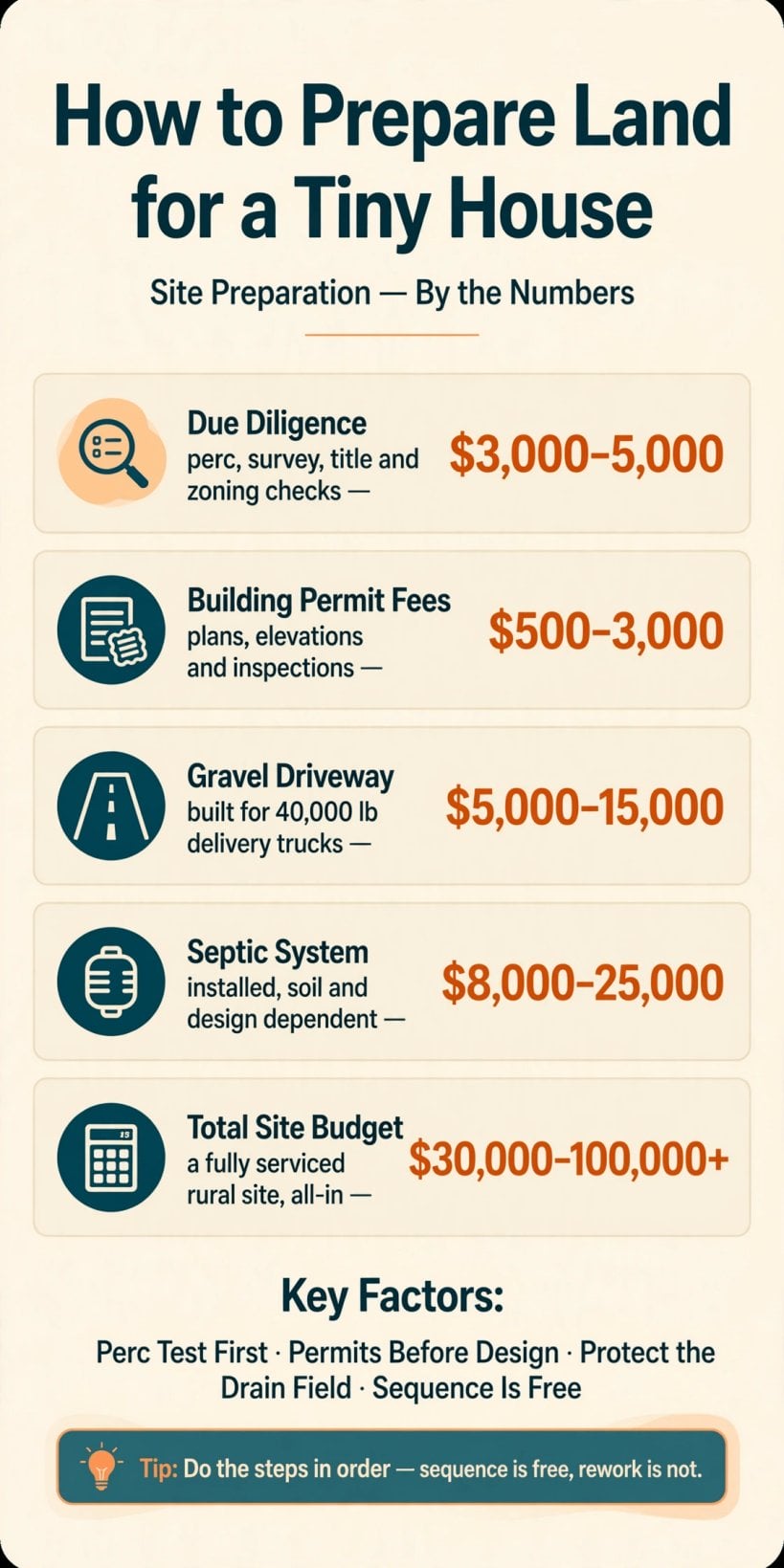

9. The Site Preparation Budget
- Due diligence: $3,000–5,000 (perc, survey, title, zoning).
- Permits: $1,000–5,000 (all permits and fees).
- Clearing and access: $6,000–20,000 (driveway is the big number).
- Excavating/grading: $3,000–12,000.
- Foundation/pad: $3,000–15,000.
- Power hookup: $2,000–10,000 (grid) or $12,000–29,000 (solar).
- Water/sewage: $10,000–35,000 (well + septic).
- Total typical: $30,000–100,000+ for a fully serviced rural site.
10. The Sequencing Master Checklist
In order: due diligence → purchase (with contingencies) → permits (all of them) → clearing and driveway → well drilling → excavation and grading → foundation/pad → septic installation (protect the field) → utility trenching → construction → final grading and landscaping. The most expensive mistake is doing things out of order (trenching before the septic design is final; building before the permits issue). Sequence is free; rework is not.
Final Considerations
Site preparation is the invisible half of the tiny house project — invisible in the photos, decisive in the budget and timeline. The owners who thrive are the ones who diligenced the land, permitted patiently, sequenced correctly, and budgeted honestly. The house is the dream; the land preparation is the discipline that makes the dream stand up. Do the discipline first.
